HIGHLIGHTS

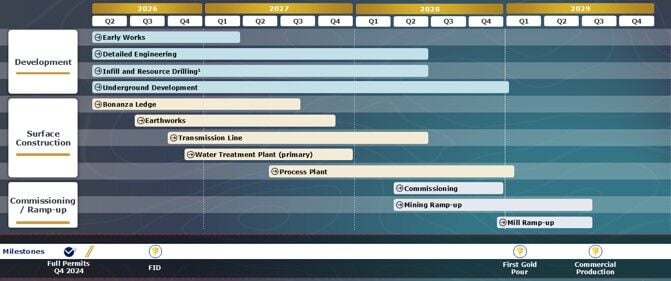

  • Cariboo Gold Project remains on schedule for anticipated first gold pour in Q1 2029 and commercial production in H2 2029
  • Project completion estimated at ~28% based on $355 million in cumulative costs incurred to September 30, 2026, with the remaining estimated budgeted cost to complete construction of ~$907 million
  • Detailed engineering is ~42% complete and over 50% of procurement packages have been awarded

Osisko Gold Provides Construction Progress Update on the Cariboo Gold Project
Osisko Gold Provides Construction Progress Update on the Cariboo Gold Project
Osisko Gold Provides Construction Progress Update on the Cariboo Gold Project
Osisko Gold Provides Construction Progress Update on the Cariboo Gold Project
Osisko Gold Provides Construction Progress Update on the Cariboo Gold Project
